Open Workbench Resource Availability Field: How Is It Derived?
search cancel

Open Workbench Resource Availability Field: How Is It Derived?

book

Article ID: 246725

calendar_today

Updated On:

Products

Clarity PPM On Premise

Issue/Introduction

It is not clear from the documentation on how 'Resource Availability' is calculated/derviced.

Availability always shows as 0.0 in OWB, however it showing in Clarity.

Environment

Release: All



Resolution

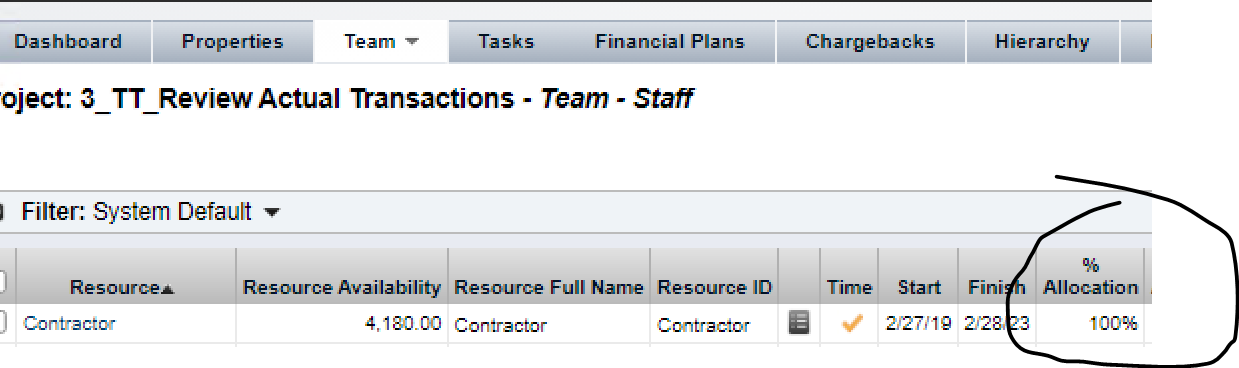

Be sure to set the % Allocation to be greater than 0.0.
Once set/saved, the calculation of Resource Availability is as follows using the following example

For a resource:
1. Availability = 8 hours per day x 5 days = 40 hrs per week

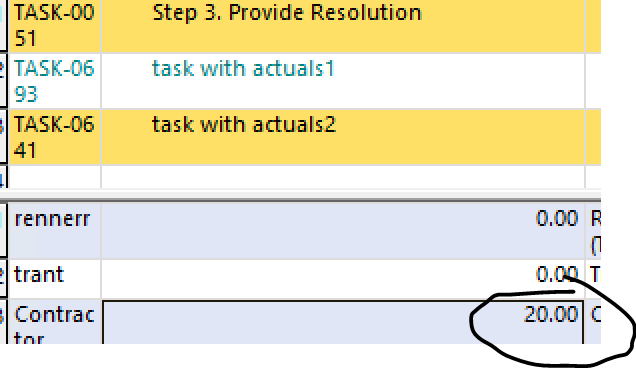

2. % Allocation = 50%

AVL x %allocation = 40 x 0.50 = 20 hours, therefore OWB will display this
