Some Specific Tasks go to "Time Overrun" once after the March DST.
Example, for the execution of the 25th March 2017 in Europe:
Main task scheduled at 10h for 23h59mins for uproc 1
specific provoked task on uproc 2 that changes the submission account and has a launch window at 13h during 59mins
specific provoked task on uproc 2_son that changes the submission account again and has a launch window at 22h during 23h59mins
The day 26th march, the uproc2_son will be on status time overrun, having an end date the 25/03/2017 at 21h59
This behavior is incorrect, job should not finish in Time Overrun.

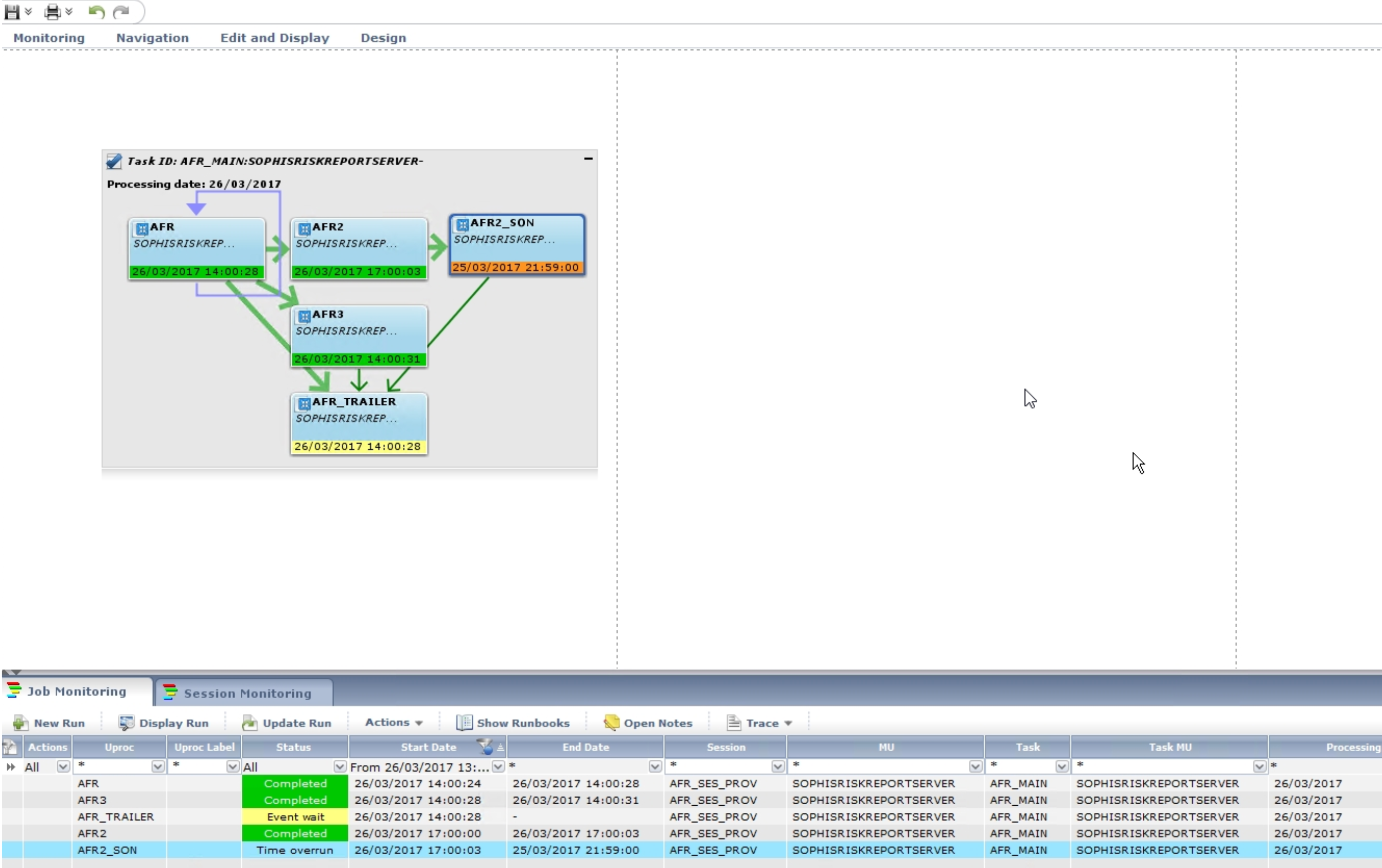

Screenshot from the Job Chain showing the affected execution:
<Please see attached file for image>
